Switchroom Installation – 110 Highett Road

Switch Room Installation –
110 Highett Road

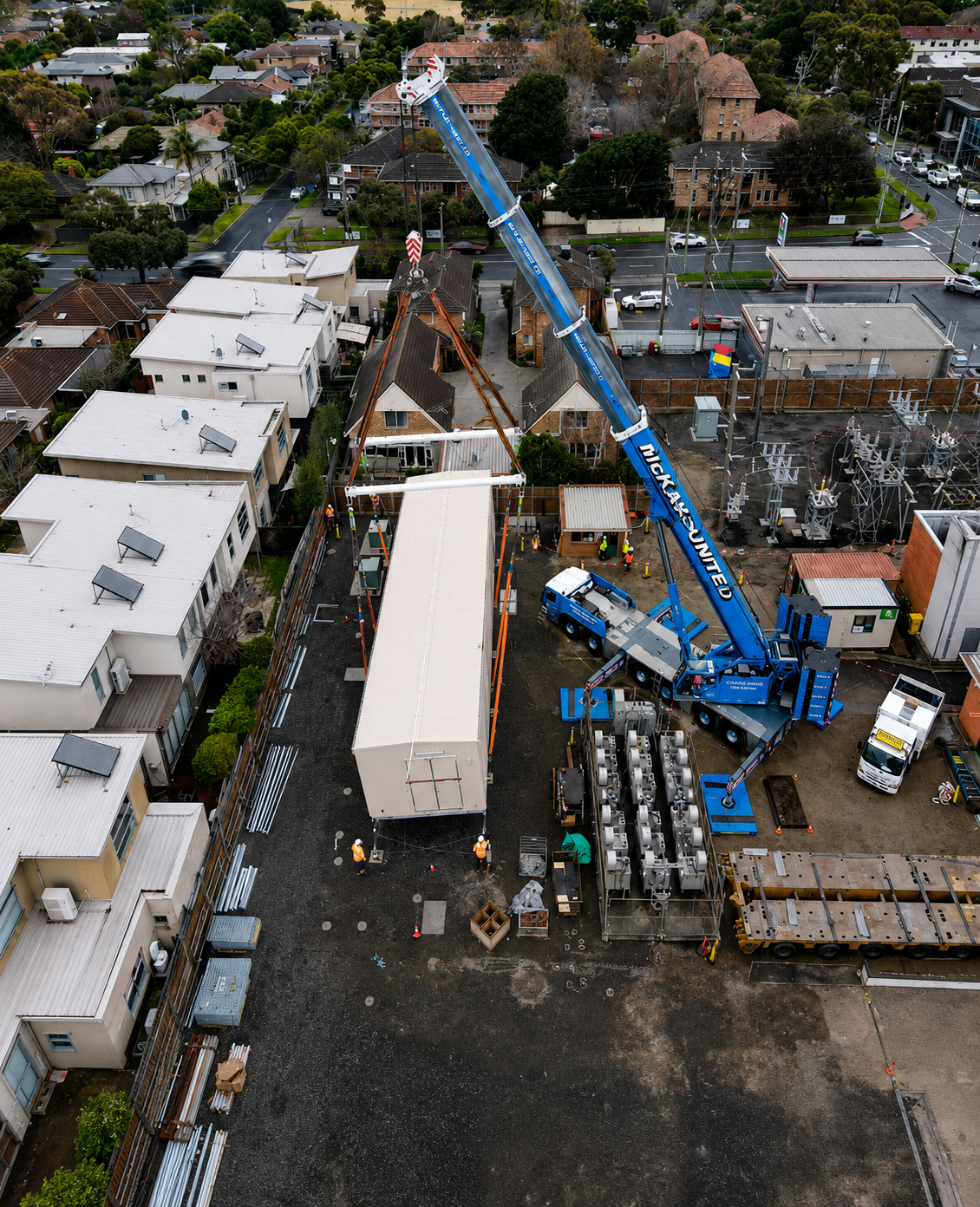

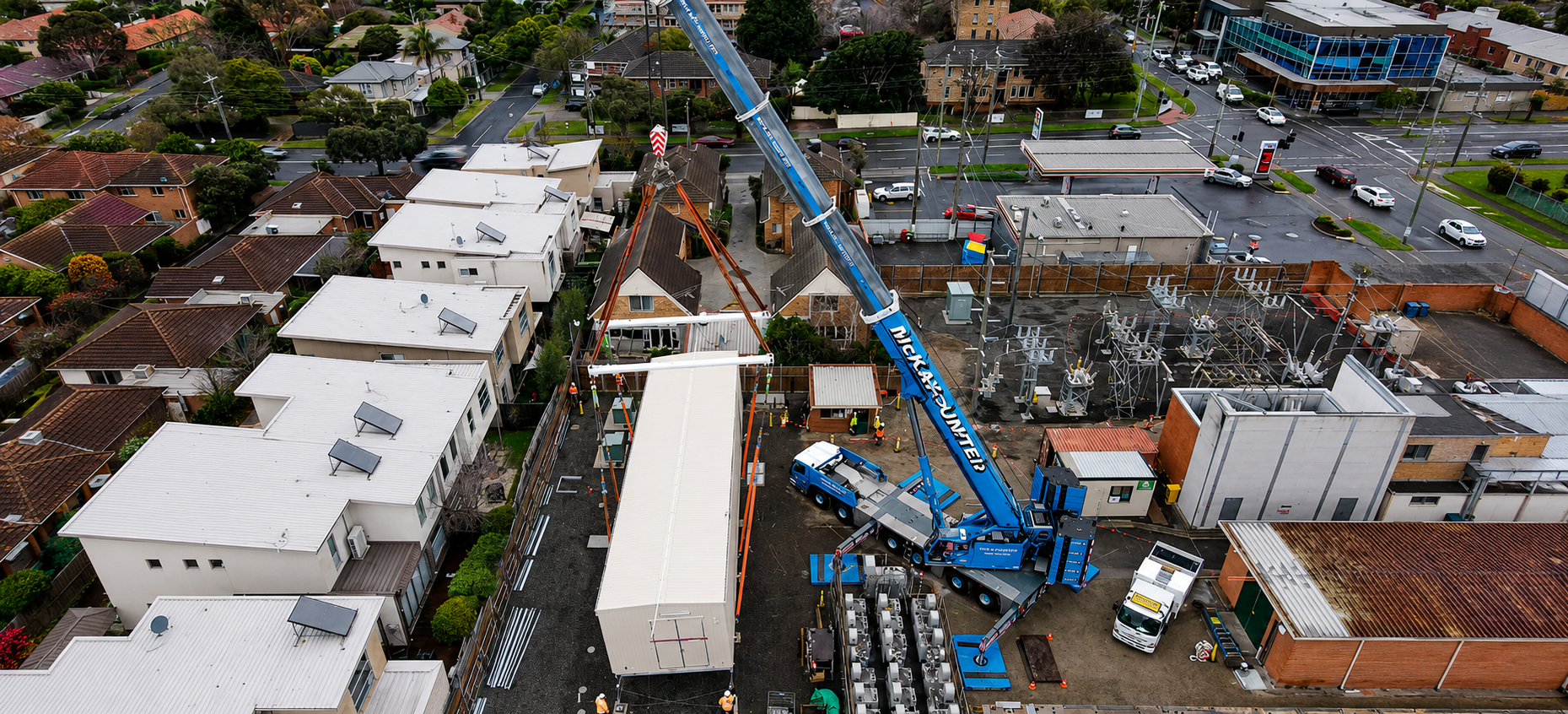

McKay United Crane Hire was engaged to provide the engineering, planning and lifting solution for the installation of a 62-tonne prefabricated electrical switch room at 110 Highett Road, Highett. The project involved the installation of a large modular structure measuring approximately 21.0 metres long, 5.7 metres wide and 2.5 metres high onto a structural support frame approximately 2.0 metres above ground level.

While the weight of the module presented a significant lifting challenge, the complexity of the project was driven by severe site constraints, restricted crane positioning, an eccentric centre of gravity, limited fly-path options and the inability to utilise larger crane configurations.

By combining specialist heavy-lift expertise, bespoke rigging systems and disciplined execution, McKay United safely completed a lift operating at the practical limits of crane performance while maintaining strict site, access and safety constraints.

The successful completion of the project required detailed engineering, bespoke rigging design and meticulous planning to achieve a lifting solution that operated within extremely tight tolerances while maintaining the highest standards of safety and control.

Sector

Infrastructure — Bridges & Roads

Client

TO BE CONFIRMED

Location

110 Highett Road, Highett

Completion

March 2024 (fictional)

Why the lift was unique

This project represented one of the most technically demanding modular installations undertaken by McKay United Crane Hire due to the combination of engineering, operational and site constraints encountered throughout the planning and execution phases.

The installation required a 62-tonne switch room to be lifted and manoeuvred within an extremely restricted operating envelope, where crane positioning was effectively governed by surrounding infrastructure and available site access. Unlike many heavy lift projects where additional lifting capacity may be achieved through larger crane configurations, this option was not available. Site constraints prevented the use of larger cranes and made the implementation of Mega Wing Lift configurations physically impossible. As a result, the project demanded an engineered lifting solution that maximised the capability of the selected crane while maintaining strict compliance with capacity, stability, ground pressure and operational requirements. The successful outcome was achieved through engineering innovation, detailed planning and precise execution rather than by increasing crane size.

Engineering the solution

From the outset, it was clear that the success of the lift would depend on engineering accuracy and detailed planning.

From the outset, it was clear that the success of the lift would depend on engineering accuracy and detailed planning. The restricted crane setup area provided very little flexibility in crane positioning, making operating radius one of the most critical design parameters. Every aspect of the lifting operation was carefully analysed, including: Crane capacity and utilisation. Centre of gravity verification. Rigging design and load equalisation. Ground bearing pressure assessment. Wind loading considerations. Fly-path restrictions and clearance requirements. Installation tolerances. Transport and access constraints. The final engineered solution utilised a Grove GMK6400 configured with 135 tonnes of counterweight and operating at a planned maximum utilisation of 99.3% of available chart capacity. At this level of utilisation, every element of the lift required careful verification and control, leaving little margin for error and reinforcing the importance of detailed engineering throughout the project lifecycle.

Planning and Execution

The successful outcome of the project was supported by extensive preparation and verification activities undertaken prior to the lift.

These included: Detailed lift studies and engineering reviews. Rigging design verification. Centre of gravity assessments. Ground bearing pressure calculations. Temporary modification of site fencing to facilitate access. Verification of crane assembly and setup locations. Dry-run simulations of the lifting sequence. Fly-path validation and clearance checks. Stakeholder coordination and pre-lift planning workshops. This proactive approach eliminated uncertainty wherever possible and ensured all project stakeholders had a clear understanding of the lift methodology before commencement of operations.

Key Challenges

Restricted Site Access and Crane Setup

The project site presented significant access and positioning challenges for both the transport operation and crane setup. Existing buildings and infrastructure restricted available working areas and limited crane placement options. The delivery of the switch room, assembly of the crane and final lifting operation all required careful coordination to ensure sufficient space was available while maintaining safe operating clearances.

The available footprint effectively dictated the crane position, meaning the engineering solution had to be developed around the site constraints rather than optimised around the crane. This restriction became one of the defining challenges of the project.


Operating at the Practical Limits of Crane Performance

The governing lift condition required the crane to operate at a planned utilisation of 99.3% of available chart capacity. While such lifts are achievable with appropriate engineering and controls, they demand a significantly higher level of planning, verification and operational discipline. Weight assumptions, rigging calculations, centre of gravity locations, crane positioning and environmental conditions all became critical project considerations. The ability to safely execute a lift under these conditions demonstrated the value of detailed lift engineering and operational expertise.

The governing lift condition required the crane to operate at a planned utilisation of 99.3% of available chart capacity. While such lifts are achievable with appropriate engineering and controls, they demand a significantly higher level of planning, verification and operational discipline. Weight assumptions, rigging calculations, centre of gravity locations, crane positioning and environmental conditions all became critical project considerations. The ability to safely execute a lift under these conditions demonstrated the value of detailed lift engineering and operational expertise.


Eccentric Centre of Gravity and Bespoke Rigging Design

The switch room incorporated an eccentric centre of gravity which required a custom-engineered lifting arrangement. To ensure balanced load distribution and maintain control throughout the operation, McKay United Crane Hire designed a bespoke rigging system comprising:

  • Eight lifting points.
  • Two 100-tonne engineered spreader beams.
  • Four 30-tonne equalising sheaves.
  • Approximately 5.6 tonnes of engineered rigging.

The equalising system enabled lifting forces to be distributed appropriately across all lifting points while compensating for the eccentric centre of gravity. This solution provided the flexibility required to fine-tune load distribution during setup while maintaining a safe and stable lifting configuration throughout the installation.


Large Module Dimensions and Load Control

Although the switch room weighed 62 tonnes, its overall dimensions created an equally significant challenge. At 21 metres in length and 5.7 metres in width, the module presented a substantial profile, which increased the importance of load control, rigging geometry and environmental  monitoring. Maintaining stability throughout the lifting operation required careful management of load orientation, crane movements and installation sequencing to ensure the module remained under complete control at all times. The combination of significant weight and large physical dimensions increased the complexity of the operation well beyond that of a conventional heavy lift.


Restricted Fly Path and Installation Accuracy

The surrounding site environment imposed strict limitations on the available fly path and crane movements. The lifting sequence was carefully engineered to ensure the switch room could be lifted, slewed and positioned without conflict with surrounding structures while maintaining safe clearances throughout the operation. The final installation also required accurate placement onto the supporting structure with limited tolerance for adjustment. Achieving this level of precision with a module of this size and weight required close coordination between crane operators, rigging personnel and site management throughout the operation.


Ground Bearing Pressure and Stability Management

Ground conditions formed a critical component of the engineering assessment due to the high crane utilisation and restricted setup area. Detailed outrigger reaction and bearing pressure calculations were undertaken to verify site suitability and confirm the crane could operate safely within the available footprint.The assessment confirmed a maximum calculated ground bearing pressure of 217.4kPa against an allowable site bearing pressure of 250kPa. This verification ensured the crane could safely perform the lift while maintaining appropriate engineering margins and operational stability.

Project Outcome

Through detailed engineering, innovative rigging design and meticulous planning, McKay United Crane Hire successfully completed the installation of the 62-tonne switch room at 110 Highett Road, Highett.

The project demonstrated the company’s ability to deliver engineered lifting solutions in situations where conventional approaches are not feasible and where increasing crane size is not an option.  By combining specialist heavy-lift expertise, bespoke rigging systems and disciplined execution, McKay United safely completed a lift operating at the practical limits of crane performance while maintaining strict site, access and safety constraints.

The successful delivery of this project highlights McKay United Crane Hire’s capability to undertake complex infrastructure, utility and industrial lifting operations where engineering precision, innovative thinking and operational excellence are critical to success.

Load Weight: 62.0 tonnes

Load Dimensions: 21.0m x 5.7m x 2.5m

Installation Height: Approximately 2.0 metres

Crane: Grove GMK6400 All Terrain Crane

Counterweight: 135 tonnes

Maximum Radius: 15.5 metres

Planned Crane Utilisation: 99.3%

Lifting Points: 8

Engineered Rigging Weight: Approximately 5.6 tonnes

Spreader Beams: 2 x 100-tonne engineered spreader beams (8.0m)

Load Equalisation: 4 x 30-tonne equalising sheaves

Allowable Ground Bearing Pressure: 250kPa

Maximum Calculated Ground Bearing Pressure: 217.4kPa
